Refund Process
The refund process streamlines managing and processing HitPay order refunds. This guide outlines steps for seamless handling and offers vital information. It’s important to maintain sufficient balance in your HitPay account (for non-card payments) and Stripe accounts (for card payments) to execute refunds. If your HitPay account balance is insufficient, navigate to Bank Payouts > HitPay Balance and click Top Up to top up manually.Topping up your HitPay balance is available for businesses in Singapore, Malaysia, and the Philippines. See Balance Top Up for the methods and fees per country.
- Singapore
- Malaysia
- Philippines
Please note that fees are not refunded
How to Process Refunds
- Web Dashboard
- POS App
Step-By-Step Refund Process for Desktop

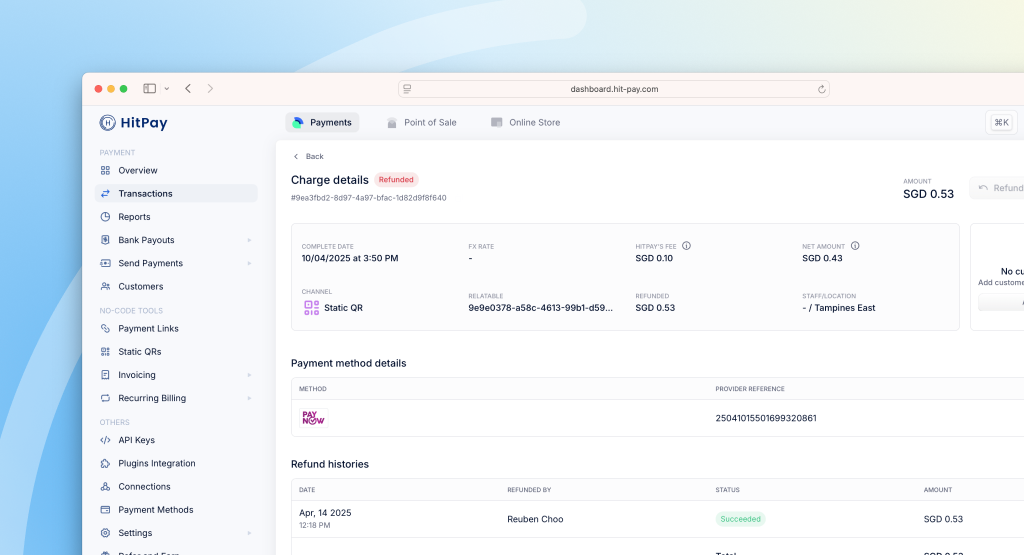

Follow these steps to process refunds using HitPay:- Navigate to Transactions
- Click on the transaction that you would like to refund
- Click on the Refund button
- Click on the Confirm button and wait for the refund success message
If you want to fully refund the transaction, leave the refund amount field empty or enter the specific refund amount if you want to partially refund the transaction.
Understanding Refund Errors
When attempting to process a refund on HitPay transactions, you might encounter errors due to two main reasons:- Insufficient Funds: If your HitPay balance does not have the necessary funds to cover the refund amount.
- Exceeded Refund Period: If the refund surpasses the allowable refund period.
- Unconfirmed Charge: Every payment method has its own charge confirmation time. This is the time it takes for the charge to move from your “Pending” to “Available to Payout” wallet balance. Charges can only be refunded after it has been confirmed. See charge confirmation times here.
- Refund Not Supported: Some payment providers do not support refunds. This includes Atome (MY), WeChatPay (MY, PH), PromptPay, QRPH (PH), Unionbank Online, PESONet, InstaPay, and Over the Counter payments (PH).
Refunds with Multi-Currency Charges
When a charge is made in a currency other than your home currency, the refund works differently from a standard same-currency refund. Example scenario: A Singapore merchant (home currency SGD) accepts a MYR 100.00 payment from a Malaysian customer.What the customer receives
The refund is issued in the charge currency — MYR 100.00 in this example. The customer's payment provider handles the funds in MYR, so they receive exactly what they paid.What balance is debited
The refund is deducted from your home currency wallet. For a Singapore merchant, that means SGD is deducted — not MYR. Because the charge currency (MYR) differs from your home currency (SGD), HitPay converts the refund amount at the live exchange rate at the time of refund — not the rate from when the original charge was made. This can result in a small FX gain or loss depending on how rates have moved between the charge and refund.If your home currency matches the charge currency (e.g., a Singapore merchant charging SGD), no currency conversion is needed and the exact charge amount is deducted from your SGD wallet.
Chargebacks
Understanding Chargebacks

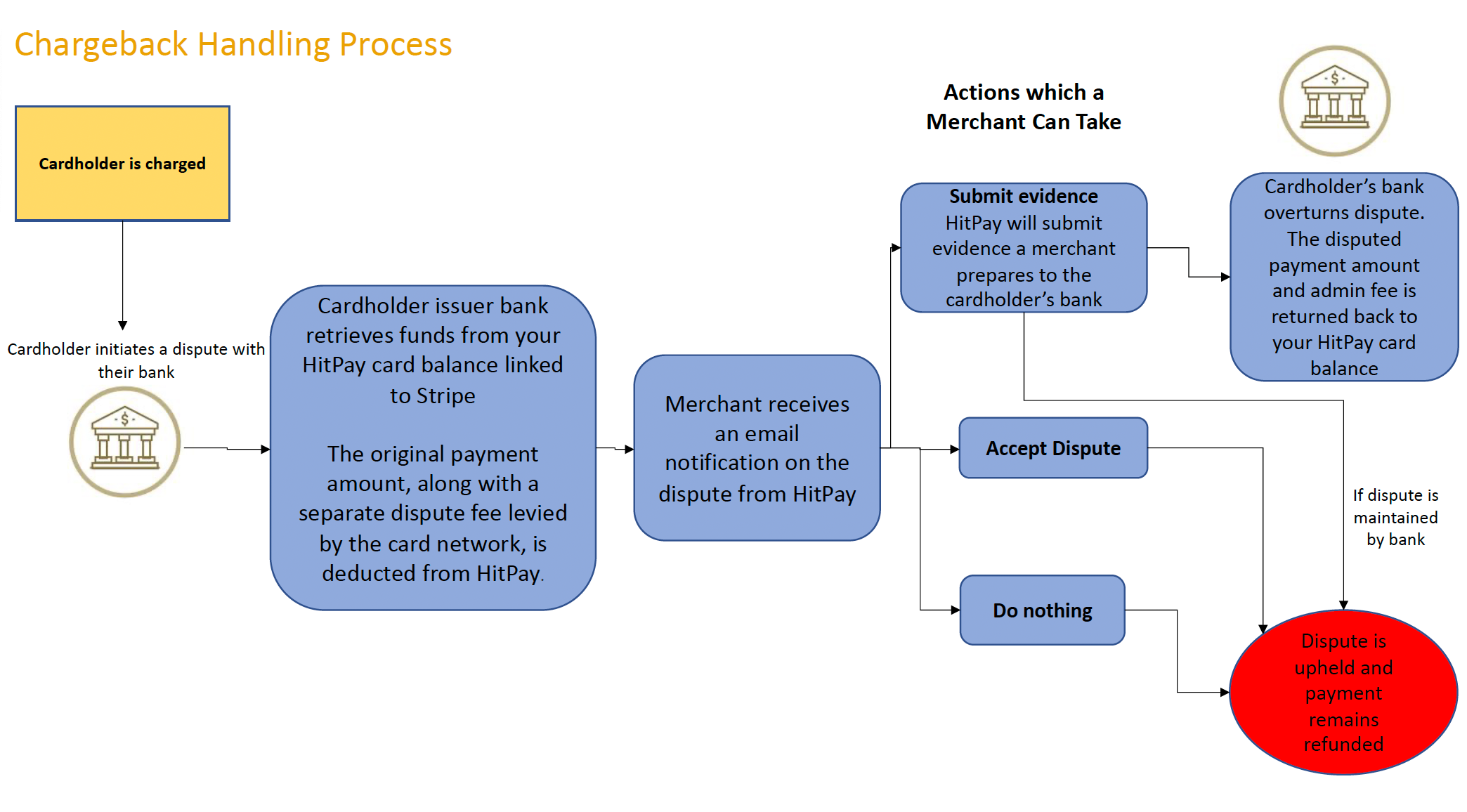

A chargeback, also referred to as a dispute, arises when a cardholder questions a payment with their card issuer (usually their bank). The card issuer initiates a formal dispute, resulting in an immediate reversal of the payment. This reversal includes both the original payment amount and an additional dispute fee mandated by the card network. The deduction is made from your HitPay account. During the dispute resolution process, HitPay deducts the original payment amount along with an administrative fee. If the dispute is resolved in your favor, the disputed payment amount and administrative fee are returned to you. However, if the dispute is upheld, the decision of the card issuer prevails, and the cardholder’s payment remains refunded.Challenging a Dispute
If you wish to challenge a card dispute, please send an email to support@hit-pay.com with the following subject header: Dispute Response: (Business Name) Include supporting documents or evidence relevant to the dispute category. For assistance in preparing a dispute challenge, consult the guidance on this page: Dispute Category Types.
Chargeback Fees and Liability
In the event of a chargeback, both the chargeback fee and the complete original transaction amount will be reversed from your merchant balance.European Union countries covered include Austria, Belgium, Finland, France, Germany, Luxembourg, Netherlands, Portugal, Ireland, Italy, and Spain
Please note that policies are subject to change without prior notice.
FAQs
When I refund a transaction, will the linked Shopify/WooCommerce order be refunded?
When I refund a transaction, will the linked Shopify/WooCommerce order be refunded?
No, you still need to mark the order as refunded in your Shopify or WooCommerce admin dashboard.
